CNC Processing From Machine Installation to Packaging: Where 18 Hours Comes From

The old claim on this page was that cnc processing from machine installation to packaging and shipment takes 18 hours. That number is not a promise, it is a floor that only applies when the setup is already done and the part is simple. This page breaks the flow into its real steps, shows which ones can run in parallel, and tells you when 18 hours is achievable and when it is not.

±0.005 mm tolerance100% inspectionNo MOQ12-hour quote

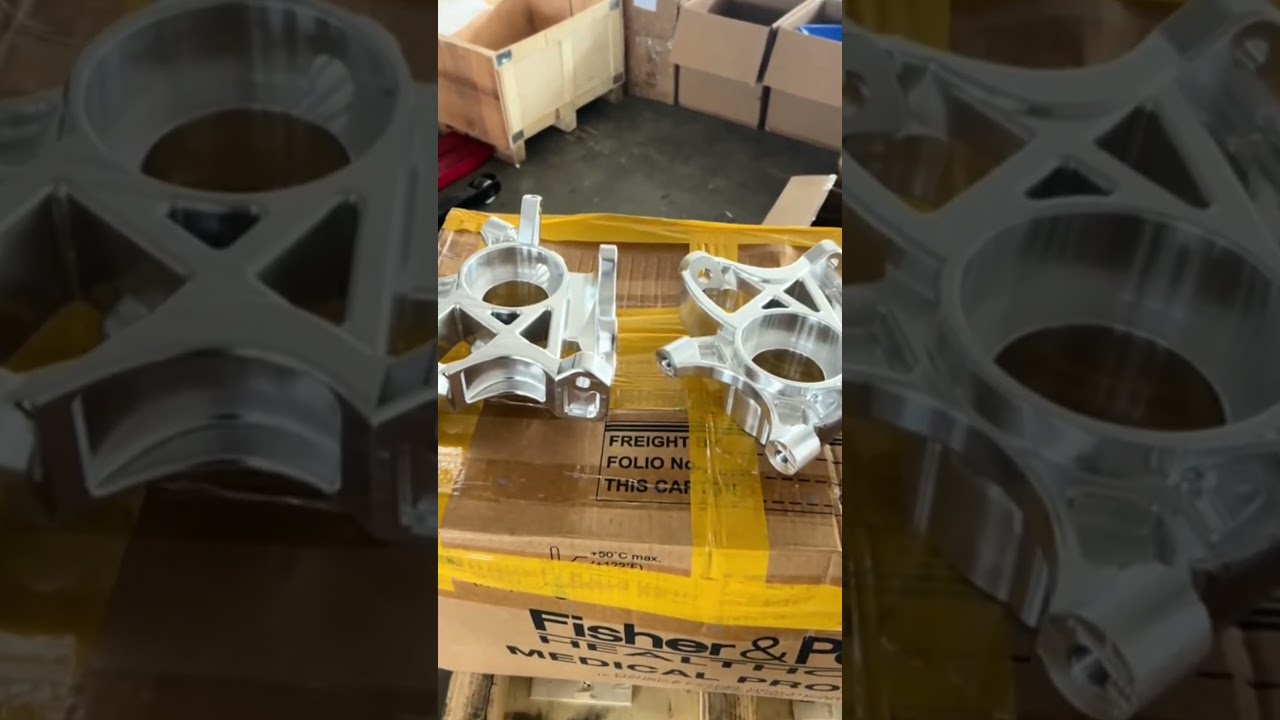

CNC processing from machine installation to packaging on a 5-axis machined engine part
Short version

Key takeaways

18 hours is a subset, not the whole jobIt describes one part moving through an already-running cell, not a project from PO to dock.
Setup is the long poleFixture building, first-article checks and tool proving dominate the clock on a new geometry.
Parallel steps buy the hours backMaterial prep, programming and inspection planning can overlap while a machine is still cutting another job.
Finish and inspection set the real floorAnodizing, plating or a CMM report adds time that no spindle speed can remove.
The clock

What the 18-Hour Number Actually Measures

An 18-hour claim sounds like a race against the clock. Read it as a measurement of one narrow window instead. It counts the time a part spends inside a working cell: loading the blank, running the cycle, moving to the next operation, deburring, checking, packing and handing to the courier. It does not count the days before that window opens, because those days are where the real engineering lives.

The window only exists after three things are finished. The program has been proven on the machine, the fixture has been dialed in, and the first article has passed inspection. Once those are done, a second, third and hundredth part can indeed move through fast. That is the honest version of the claim.

So the useful question is not whether 18 hours is true. It is what has to be true for it to be true. A one-off bracket with a single setup and no finish behaves very differently from a thin-walled aluminum housing that needs five operations, two fixtures and a hardcoat. Same shop, same machines, wildly different clocks.

We quote and run both. The point of this page is to show you which side of the line your part lands on before you commit to a date.

  • 1
    In the windowCutting, in-process checks, deburr, wash, final inspection, pack, ship.
  • 2
    Outside the windowDFM review, programming, fixture build, material ordering, outside finishing.
  • 3
    The hingeWhether the geometry is already proven on a machine.
Step 1

Machine Installation and Readiness: The Hidden First Step

Machine installation is not the same as machine availability. A 5-axis center that arrived last week is not a resource until it is leveled, geometrically aligned, warmed up and cut against a known artifact. On a new cell we check squareness, spindle runout and rotary axis center before a single customer part goes on the table. That work happens once, and it protects every part that follows.

On an existing cell, the equivalent step is much shorter. The operator confirms the offsets, checks the tool setter, and runs a warm-up cycle. If the machine has been cutting the same family of parts, this takes minutes. If it has been idle for a week, thermal drift is real and we let the spindle stabilize before touching a tight tolerance.

This is why 'machine installation to shipment' is a misleading phrase when applied to a running shop. In our plant, 127 high-precision CNC machines are already installed, aligned and in production. We are not installing a machine to make your part. We are scheduling your part onto a machine that is already stable enough to hold ±0.005 mm.

The only time installation enters your timeline is if the job requires a capability the current cell does not have, such as a 4,000 mm travel for a long extrusion. Then tooling, workholding and probe setup become project steps, and the clock starts after them.

Step 2

Programming, Fixtures and First Article

Programming is where most of the engineering time goes on a new part. A simple 2.5D profile might take under an hour to post and simulate. A complex 5-axis surface with tight blend radii can take a full shift, because we simulate the actual toolpath, check for gouges and verify that the tool holder clears the walls at every angle.

Fixture design runs alongside programming, not after it. Soft jaws, a modular vise, a vacuum plate or a custom tombstone all have to hold the part rigidly without marking it and without blocking the cutting path. On thin-walled parts the fixture is often the difference between a 0.1 mm bow and a flat part. Machining a part on a weak setup and then blaming the machine is a common way to lose a day.

The first article is the gate. We cut one part, measure the critical features against the drawing, and adjust offsets before releasing the rest. On a ±0.005 mm feature that means a CMM or a high-accuracy gauge, not a caliper. If the first article is good, the run goes. If it is not, we change the process, not the tolerance.

In our flow, quotation and free DFM analysis come back within 12 hours, and production can start within 24 hours. That 24 hours covers the programming and fixture preparation for a typical part. It is not the same 18 hours as the cutting window, and we do not pretend it is.

  • 1
    Simple prismatic partProgramming under 1 hour, standard vise, first article same shift.
  • 2
    Complex 5-axis partProgramming a full shift, custom workholding, first article next shift.
  • 3
    Thin wall or tight flatnessFixture design drives the schedule, not the spindle.
Step 3

Cycle Time, Tool Changes and the Cutting Window

Once the process is proven, cycle time is mostly arithmetic. Material removal rate depends on the alloy, the cutter, the spindle power and the rigidity of the setup. Aluminum 6061 cuts fast and forgiving. 17-4PH stainless and Inconel do not, and a part that runs in 20 minutes in aluminum can run for three hours in Inconel at the same tolerance.

Tool changes are a quiet tax. A job with 18 tools across two operations spends real minutes in the changer. We group tools to cut that number, and we keep duplicate cutters loaded so a worn edge does not stop the run. On a 10,000-part order the same saving compounds, but even on a single part it keeps the window tight.

Multi-axis work changes the math in a good way. A 5-axis center can reach five faces in one setup, which removes a re-fixture, a re-datum and the stack-up error that comes with them. On a complex housing, one 5-axis setup can replace three 3-axis operations. The cycle may be longer, but the floor-to-floor time is shorter.

That trade is the core of the 18-hour story. Fewer setups, less handling, less waiting between operations. The cut itself is rarely the bottleneck.

Step 4

Finishing, Inspection and Packaging

Finishing is the step that breaks fast timelines, because it usually leaves the building. Anodizing, electroless nickel, zinc plating, powder coating and black oxide are done by qualified outside processors with their own queues. Clear anodize on a small batch can turn around quickly. Hardcoat, conductive anodize or a specific color match takes longer, and no amount of spindle speed changes that.

Inspection is the other fixed cost. We inspect 100% of parts before shipment, with raw material checks, in-process monitoring and a final inspection, and we provide reports on request. On a tight feature that means CMM time, which is scheduled, not rushed. A first article and a final report on the same part can be two separate inspection events.

Packaging is short but not zero. Machined surfaces scratch. Sharp edges cut through foam. We clean, deburr, protect critical faces and pack to survive international freight, which matters more on a 4,000 mm part than on a palm-sized bracket.

Add it up and the honest floor for a finished, inspected, packed part is often closer to two to three days. The 18-hour figure fits when finishing is in-house or not required and inspection is a dimensional check rather than a full report.

  • 1
    As-machined, no finishFastest path, the cutting window is the whole story.
  • 2
    Anodize or platingAdds outside processing time you cannot compress.
  • 3
    Full inspection reportAdds scheduled CMM time before packing.
Boundaries

When 18 Hours Is Realistic and When It Is Not

Eighteen hours is realistic for a repeat part on a proven process. The program exists, the fixture exists, the material is on the shelf, and the finish is either as-machined or an in-house step. A batch of aluminum brackets, a set of stainless fittings, a small run of titanium spacers. Load, cut, check, pack, ship. That is a genuine one-shift-plus job.

It is not realistic for a new geometry with tight tolerances and an outside finish. The first article alone can consume a shift. Add a hardcoat and a CMM report and you are at two to three days, sometimes more if the material has to be ordered. A shop that quotes 18 hours on that job is either skipping the checks or planning to miss the date.

Material availability is the underrated variable. We stock common grades like 6061, 304 and 1018, but 7075 plate, 17-4PH bar and titanium in the size you need may not be on the floor. Waiting on material is not a machining problem, and it does not show up in a cycle-time calculation.

There is also a size effect. A part within a 500 × 500 × 450 mm envelope is easy to handle and inspect. A 4,000 mm extrusion needs special workholding, longer setup and a bigger inspection plan. The geometry may be simple, but the logistics are not.

Decision table

Which Timeline Applies to Your Part

Read the left column first, then find your finish and inspection needs.

Part situationRealistic windowMain time driver
Repeat part, proven program, no finishUnder 18 hoursCycle time and handling
New simple part, standard vise, as-machined1–2 daysProgramming and first article
Complex 5-axis part, new fixture2–4 daysProgramming and workholding
Any part with anodize or plating3–6 daysOutside finishing queue
Tight tolerance with CMM report3–5 daysScheduled inspection time
Exotic alloy not in stockAdd 3–10 daysMaterial lead time
Part over 1,000 mmAdd 1–2 daysFixture and handling

The Clear Trade

If you need a proven repeat part in a day, keep the finish in-house and skip the full report. If you need a new tight-tolerance part with anodize and a CMM report, plan for days, not hours, and let us start the outside finishing queue early.

FAQs

Questions engineers ask next

Does the 18-hour window include programming and fixture building?

No. It covers the time a part spends inside an already-proven cell: cutting, in-process checking, deburring, final inspection, packing and shipping.

Programming and fixture work happen before that window opens. For a new geometry they usually take longer than the cutting itself.

How fast can a real order start?

We return a quotation and a free DFM analysis within 12 hours, and production can start within 24 hours for a typical part.

That 24 hours is when programming, material picking and fixture preparation happen. It is separate from the cutting window.

What tolerance can a fast turnaround still hold?

Our standard capability is ±0.005 mm (±0.0002 in), and we hold it on parts that run in a normal schedule.

Compressing the schedule does not change the tolerance. It changes how many checks we can run before the part leaves, which is why we do not shorten inspection.

Which finishes can be done in-house?

Bead blasting, tumbling, brushing and polishing can be handled in our own flow, along with laser marking down to a 1.5 mm character height.

Anodizing, plating, powder coating and black oxide go to qualified outside processors, and those queues sit outside the machining window.

Is there a minimum order for a fast run?

No. We run from one prototype to 10,000+ part runs with no minimum order quantity.

A single part and a production batch use the same process discipline, but the per-part setup cost is obviously higher on the single piece.

What surface finish should I specify?

As-machined sits around Ra 1.6–3.2 μm, a good high-finish target is Ra 0.8–1.6 μm, and fine finishing reaches Ra 0.2–0.8 μm.

Tighter finish means slower passes and more inspection, so specify the coarsest value that actually works for the mating surface.
